Home News African Mineral Processing EPC: 10 kt/d Heavy-Mineral-Sands Line Delivered in 65 Days

African Mineral Processing EPC: 10 kt/d Heavy-Mineral-Sands Line Delivered in 65 Days

Time: 2026-09-16 Clicks: 0

If you want to know more information (such as product/process price, etc.), please contact us 24-hour telephone

24-hour telephone: +86 138-1151-0145

How to build a stable concentrator and reach full production quickly is a key challenge for Chinese mining enterprises expanding into Africa. Xinhai delivered a full‑scope EPC+M+O (Engineering, Procurement, Construction + Management & Operation) wet‑processing production line 10 000 t/d heavy‑mineral‑sands project in Mozambique. The contract was awarded in May 2023; construction drawings were finalised in July 2023, and the whole project moved from drawing‑board to commissioned production in just over two months. This large‑scale heavy‑mineral‑sands project offers valuable lessons for reference.

Strategic Zirconium‑Titanium Minerals: African Market Opportunities

Zirconium and titanium are strategic mineral commodities with highly concentrated global resources. The world’s total zircon reserves stand at around 75 million tonnes; Mozambique, South Africa, Kenya and Australia together account for 84 % of this total. Eastern Mozambique hosts laterite‑type and coastal placer‑type zircon‑titanium heavy‑mineral sands. Run‑of‑mine feed contains over 3 % TiO₂; minerals occur as discrete naturally‑liberated grains, making them relatively easy to separate. As Chinese mining investors turn their attention to the East African coast, constructing a reliable concentrator adjacent to mineral tenements is usually the first priority for developing heavy‑mineral‑sands deposits.

Nevertheless, coastal projects in this region bring inherent site‑specific hurdles: salt‑rich coastal atmosphere accelerates equipment corrosion, rainy seasons impose constraints on civil‑works timelines, and local spare‑part supply chains remain limited. All these real‑world local factors were weighed throughout the engineering phase of this Mozambican project.


65‑Day Drawing Delivery: Design Adapted to African Project Timelines

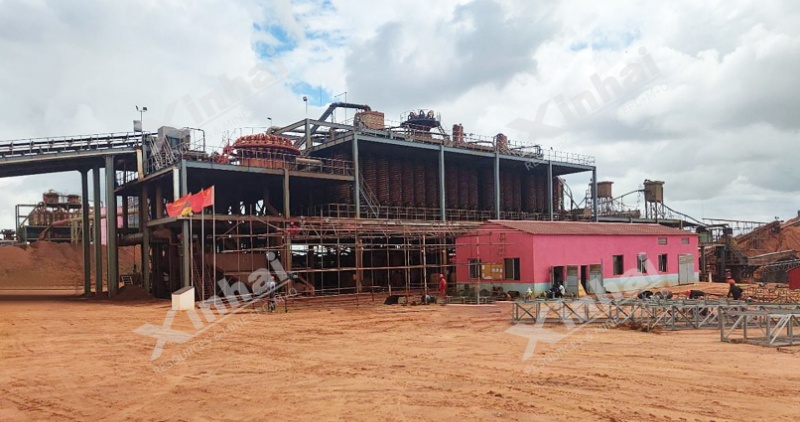

The project contract was signed on 22 May 2023. Full construction documentation including steel‑structure, water‑supply‑and‑drainage and general‑layout drawings was completed and issued electronically on 27 July 2023 — a total turnaround of roughly 65 days. Design work was based on metallurgical test reports and proven operational data from comparable plants, with process flows confirmed after preliminary‑design review. Four core design principles were followed:

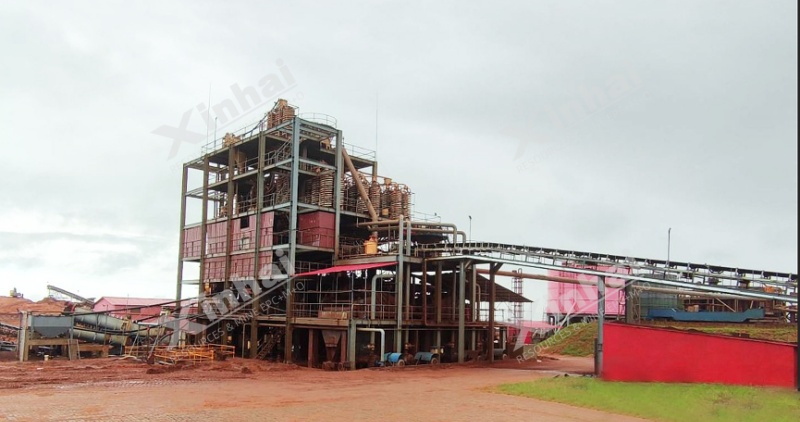

Seven‑Stage Main Beneficiation Circuit

The main processing circuit consists of seven sequential unit operations with the following functions and outputs:

Table 1|Seven‑stage wet‑processing circuit for heavy‑mineral sands
No.Unit OperationFunction / Output
1Feeding & Pulping (waste‑discarding pre‑treatment)Wet and disperse ROM ore; remove tramp impurities
2Cyclone deslimingClassification and desliming to mitigate interference from fine‑size fractions
3Spiral concentrator gravity separationOne roughing, one cleaning, one scavenging; separate zircon‑titanium minerals from silica sand
4Low‑intensity magnetic separationRecover titanomagnetite
5High‑gradient high‑intensity magnetic separationProduce rough ilmenite concentrate
6Zircon‑beneficiation circuit (spiral rough‑scavenging + shaking‑table cleaning)Generate rough zircon‑concentrate
7Tailings handlingDewater for stockpile; clarify and recycle process water

Plant workshops adopt compact layout with centralised control. Ore slurry flows by gravity taking advantage of site topographic relief. Final product specifications: titanium concentrate TiO₂ 40‑42 % with overall recovery above 85 %; zircon concentrate ZrO₂ 35‑40 % with recovery above 80 %.


33‑Day Commissioning: From Drawings to Stable Production

Commissioning lasted 33 days in total. Line 1 accumulated 756 operating‑hours. Key operational statistics are shown below:

Table 2|Key performance indicators during Line 1 commissioning
IndicatorValue
Commissioning duration33 days
Line 1 total runtime756 hours
Equipment availability (power‑outage time excluded)95.45 %
Cumulative ore throughput233 240 tonnes
Maximum daily feed capacity9 275 tonnes
Zircon‑concentrate production971.70 tonnes (equivalent to 313.96 tonnes zircon‑metal content)
Average yield / Average grade0.42 % / 32.31 %

Two on‑site process optimisations delivered major cost‑saving and stability gains throughout commissioning:

Commissioning represents practical iteration between theoretical process design and real‑site conditions. Stable target‑grade output marks successful hand‑over to full‑scale production.


EPC+M+O: Replicable Project‑delivery Capability

EPC+M+O integrates engineering, equipment supply, construction‑commissioning and production‑operation services end‑to‑end. Three replicable practical take‑aways were distilled from this Mozambican project:

For enterprises planning to construct heavy‑mineral‑sands concentrators in Africa, cost‑efficient operation must be built‑in from project inception rather than retrofitted after plant startup. Lessons learned from this 10 kt‑d heavy‑mineral‑sands delivery have become transferable know‑how applicable to subsequent mineral‑sands projects.
